PCB production line used for scheduled volume fabrication

Controlled Scale-Up

Mass Production PCB Manufacturing with Defined Release Gates

Mass production PCB manufacturing is recurring bare-board fabrication from an approved design, with controlled materials, panelization, tooling, inspection and shipment releases. APTPCB supports scheduled production across standard and advanced PCB constructions, with coordinated assembly available when required.

Gerber / ODB++
Fabrication Release
Class 2 / Class 3
Specified Order Criteria
FAI / CoC
Requested Records

Get an Instant Quote

NPI to VolumeControlled Transfer
V-Cut / RoutingPanel Review
Specified SPCCritical Parameters
Class 2 / Class 3Bare-Board Options
HDI / Rigid-FlexAdvanced Constructions
Scheduled LotsAgreed Release Plan
AOI + E-TestDefined Inspection
Batch RecordsTraceable Release
NPI to VolumeControlled Transfer
V-Cut / RoutingPanel Review
Specified SPCCritical Parameters
Class 2 / Class 3Bare-Board Options
HDI / Rigid-FlexAdvanced Constructions
Scheduled LotsAgreed Release Plan
AOI + E-TestDefined Inspection
Batch RecordsTraceable Release

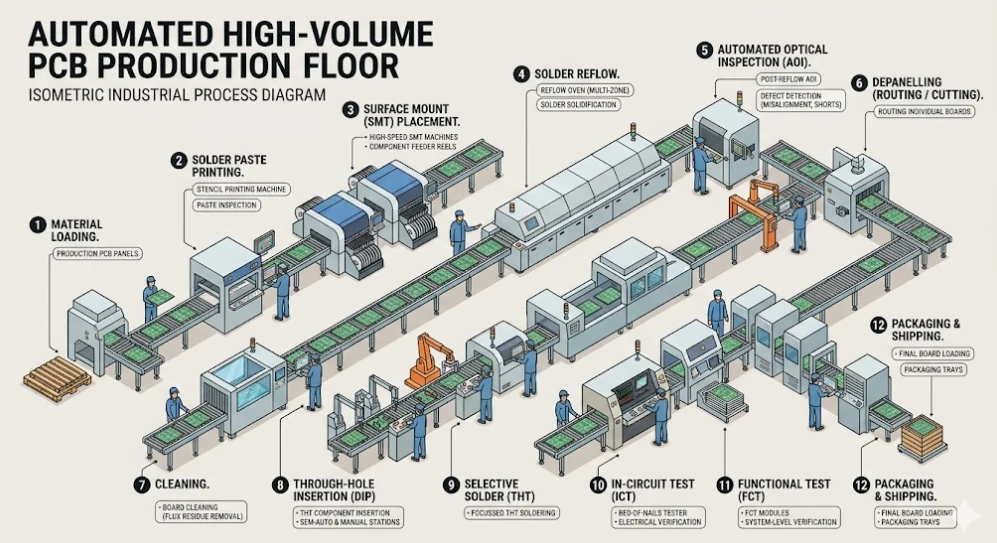

Production Transfer

What Changes When an Approved PCB Build Moves into Volume Production?

A volume program is not simply a larger version of a prototype order. The release must freeze the fabrication data, approved materials, panel array, tooling, inspection plan, documentation, and change-control rules. The transition normally starts after an NPI or pilot build has resolved design and process risks.
For assembled products, APTPCB can coordinate fabrication with component sourcing and turnkey assembly. Recurring populated-board programs are covered by high-volume PCB assembly, including BOM, placement and assembly-test release. Customer approval remains required for design changes, material substitutions, component alternates and product-level compliance decisions.
APTPCB’s published factory profile lists PCB fabrication capacity of 100,000 m² per month and a 20,000 m² fabrication footprint in Shenzhen, with rigid, flexible, rigid-flex, HDI, aluminum and high-frequency PCB capabilities. These factory figures describe advertised overall scale; the proposed construction, material, production route and delivery allocation are confirmed for each order. Class 2 and Class 3 options, AOI and electrical testing support the agreed bare-board acceptance plan.
ESI 5335 laser drilling system at the APTPCB PCB factory

Comparable Volume Quotations

What Must Match When Comparing Volume PCB Quotes?

Compare the same board construction, committed quantities and release obligations. A lower unit price can carry different tooling, inventory or shipment conditions.
DecisionState in the RFQConfirm in the Quotation or Release Plan
Forecast and firm orderAnnual or monthly forecast, firm purchase quantity and expected repeat frequency.Which quantity sets the unit price, which demand is binding and when future releases become firm.
Production lot and shipmentsBoards per manufacturing lot, shipment quantities, destinations and required ship dates.Whether lots are built together or separately, split-delivery charges and any agreed over- or under-delivery allowance.
Recurring price and toolingReleased revision, expected repeat orders and any existing panel or test tooling.Separate board price from CAM, tooling and electrical-test fixture charges; define ownership, reuse, maintenance and revision costs.
Construction and materialLaminate, stack-up, finished copper, finish, impedance and approved alternatives.The quoted construction and material availability; no material or stack-up substitution without the required approval.
Material and inventory commitmentForecast uncertainty, buffer needs, storage period and likely rescheduling.Responsibility for committed material, work in progress and finished boards, including cancellation, storage and rescheduling terms.
Schedule start and shipment dateRequired ship dates, file-release status and outstanding engineering approvals.What starts the lead-time clock, material and tooling dependencies, change cutoffs and shipment date versus arrival date.
First-lot and repeat-lot evidenceFirst-article approval criteria, electrical-test scope, sampling and required reports.What is checked on the first lot and each repeat lot, which records accompany shipment and who authorizes release.
Changes between ordersControlled revision, restricted materials or processes and customer approval contacts.How design, material, site or process changes are proposed, approved and reflected in tooling, price, schedule and acceptance evidence.

These are items to agree for the program, rather than standard commercial terms. Panel utilization follows board geometry, array constraints and the manufacturing panel; order volume alone does not determine utilization, unit price or lead time. Planning tiers: 500–2,000 m²/month: 10–15 days standard; 2,000–5,000 m²/month: 10–15 days with expedite available; 5,000–10,000 m²/month: 7–10 days with a possible dedicated slot; 10,000+ m²/month: 5–7 days for scheduled releases. These planning offers depend on order, material, capacity, approved construction and release schedule; confirm the applicable lead time in the quotation.

Buyer Release Checklist

Mass Production PCB and PCBA Release Inputs

Use this table to define what must be accepted before tooling, material commitment, fabrication, assembly, and shipment release.
Release ItemBuyer InputFactory ControlAcceptance Output
Fabrication DataGerber or ODB++, fabrication drawing, stack-up, impedance and finishCAM and DFM review against the approved revisionReleased fabrication package and documented exceptions
Panel and ToolingBoard outline, keep-outs, breakaway method and handling limitsV-score or routed-tab array, rails, tooling holes and fiducialsApproved panel drawing and tooling plan
Assembly DataBOM, approved vendor list, CPL, drawings and polarity notesPackage, footprint, lifecycle and placement-data reviewReleased BOM and approved alternate list
Pilot / First ArticleApproval criteria and reference sample requirementsBuild record, dimensional checks and process verificationSigned release or corrective-action list
Inspection and TestApplicable IPC class and customer specification; IPC-6012 / IPC-A-600 for rigid bare boards and IPC-A-610 for assembly when specifiedAOI and electrical test, plus SPI, X-ray or FCT when specifiedAccepted control plan and report set
Delivery PlanBatch quantities, ship dates, destinations and packaging rulesLot identification, storage controls and split-release scheduleConfirmed release calendar and logistics terms
RFQ Release PackageTarget quantities, forecast, required dates and commercial termsCapacity, material, tooling, test and documentation reviewQuoted scope with assumptions, exclusions and open items

Do not release a recurring build from an obsolete file set. The purchase order, approved revision, deviation record, and requested quality documents should identify the same controlled configuration.

Production Release Gates

Six Gates from Approved Data to Shipment

Each gate has an owner, acceptance evidence, and a defined response when requirements are not met.
01

Data Package Acceptance

Confirm revision alignment across fabrication files, drawings, stack-up, impedance targets, BOM, CPL, assembly drawings, test requirements, and requested records. Open conflicts are closed before tooling or material commitment.
02

Panel and Tooling Acceptance

Approve array orientation, rails, fiducials, tooling holes, V-score or routed tabs, depanelization limits, stencil data, and electrical-test tooling. The released drawing becomes the production reference.
03

Pilot and First-Article Acceptance

Where required, verify dimensions, stack-up, impedance, soldering results, critical components, test fixtures, and reference samples in a controlled pilot or first-article build before recurring release.
04

Process and Change-Control Acceptance

Lock approved materials, component sources, process routes, inspection points, and deviation authority. When required by the control plan, SPC is applied to designated critical parameters; substitutions, process changes, and required capability evidence follow documented approval.
05

Inspection and Test Acceptance

Release only after the agreed control plan is complete. Evidence may include AOI, electrical test, impedance coupons, dimensions, microsections, SPI, X-ray, in-circuit test, or functional test according to the product.
06

Shipment and Documentation Acceptance

Match lot identity, quantity, packaging, destination, release date, Certificate of Conformance, test reports, material records, and any customer-specific documents before shipment authorization.

Application Controls

How Release Priorities Change by Application

Manufacturing controls support the product specification; final safety, regulatory, and system compliance must be validated by the customer at product level.
Consumer Electronics

Panel Utilization and Component Availability

Consumer programs usually prioritize stable revisions, material utilization, approved alternates, cosmetic criteria, packaging, and a release cadence aligned with product demand.
Automotive and EV

Traceability and Change Control

Automotive programs may specify IATF 16949 quality-system requirements, customer-specific requirements, PPAP elements, defined special characteristics, supplier-change approval, lot traceability, and agreed records.
Telecommunications

Stack-Up and Impedance Stability

High-speed and RF programs should lock the stack-up, laminate, copper distribution, impedance coupons, test method, and approved material substitutions before recurring release.
Industrial Automation

Lifecycle and Environmental Requirements

Industrial controllers often need long component availability, controlled coatings or finishes, robust connector and power sections, and documented changes over an extended product lifecycle.
Medical Devices

Documented Quality-System Scope

Medical programs may require production under an ISO 13485 quality system with defined traceability and records, while device safety, validation, and regulatory approval remain the responsibility of the legal manufacturer.
Energy and Power

Thermal and High-Current Verification

Power products should define copper weight, thermal path, spacing, laminate, coating, electrical test, and system-level thermal or safety validation before production release.

Cost and Risk Control

What Actually Changes the Unit Cost in Volume PCB Production?

Volume pricing depends on the controlled production model, not quantity alone. The largest cost and risk levers are material utilization, tooling, inspection time, component availability, change frequency, documentation, and the delivery schedule.

1. Panel Utilization and Depanelization

CAM review evaluates board rotation, array size, rails, spacing, tooling holes, fiducials, and the choice between V-score and routed tabs. A dense array can reduce material waste, but it must still remain stable during fabrication and assembly and must depanel without damaging components or copper features.

2. Tooling and Test Amortization

Recurring programs may justify dedicated electrical-test fixtures, stencils, assembly carriers, depaneling tools, or functional-test fixtures. The quotation should separate non-recurring tooling from recurring unit cost and state when a tool must be repaired or replaced.

3. DFM and Assembly Process Stability

Stable soldering and placement depend on pad geometry, thermal balance, fiducials, component spacing, stencil design, moisture controls, and the approved reflow or selective-soldering process. Design changes after release can invalidate tooling and process evidence.

4. BOM Lifecycle and Approved Alternates

The BOM review identifies obsolete, allocation-sensitive, single-source, and long-lead components. Alternate parts should be evaluated against the customer's electrical, mechanical, firmware, compliance, and lifecycle requirements and used only after approval.

5. Traceability and Release Documentation

Batch identification connects the shipped product to the controlled revision, material and component lots, process route, inspection results, deviations, and release records. The required retention period and document package should be agreed before production starts.

Frequently Asked Questions

Mass Production PCB Manufacturing FAQ

What order size counts as mass production?
There is no universal quantity threshold. A program becomes mass production when recurring volume justifies fixed panel arrays, dedicated tooling, controlled change management, scheduled releases, and a documented inspection plan. We confirm the production model after reviewing the design, monthly demand, and delivery schedule.
What should be included in an RFQ for volume PCB or PCBA production?
Provide Gerber or ODB++, drill data, fabrication drawings, stack-up, material, copper, finish and impedance requirements. Separate forecast demand from firm order quantity and requested shipment releases, and specify acceptance criteria, reports and change restrictions. For optional assembly, add the BOM, approved vendor list, placement data, assembly drawings, test requirements and approved alternates.
Is a pilot or first-article build required before volume release?
A pilot or first-article build is recommended when the design, material, tooling, supplier, assembly process, or test method is new or changed. The release should define what must be approved, such as dimensions, stack-up, impedance coupons, soldering results, functional tests, and the reference sample.
Which PCB technologies can move into scheduled production?
APTPCB supports rigid FR-4 multilayer, flexible, rigid-flex, HDI, aluminum or metal-core, heavy-copper and high-frequency or low-loss PCB programs. The approved stack-up, material availability, panel design, manufacturing route and inspection plan determine the production schedule. Capability options are reviewed together for the actual construction rather than assumed to combine at every limit.
How are component shortages and substitutions controlled?
The BOM review identifies lifecycle, lead-time, packaging, and sourcing risks before release. Proposed alternates must meet the required form, fit, function, electrical, and compliance criteria and must be approved by the customer before use. No unapproved substitution should enter production.
Which standards and quality records can support a volume program?
Class 2 and Class 3 bare-board options are available. Specify the applicable standard, revision and class in the purchase order: IPC-6012 addresses rigid-board performance and IPC-A-600 bare-board acceptability; IPC-A-610 applies to assemblies. Request the current quality-system certificate, manufacturing site and scope required by your program, including ISO 9001, IATF 16949 or ISO 13485 where applicable. Agree customer-specific criteria, traceability and reports before release; manufacturing acceptance does not replace product-level qualification.
How is lead time set for a mass-production order?
Lead time is confirmed after material, tooling, component availability, panel quantity, test coverage, documentation, and release cadence are reviewed. Recurring programs can use scheduled releases, but the agreed plan should define forecast windows, firm-order dates, and change cutoffs.
How are bare boards and assembled boards tested at volume?
The test plan is design-specific. Bare-board release may combine AOI, electrical test, dimensional inspection, impedance coupons, and microsection sampling. PCBA release may add SPI, AOI, X-ray for hidden joints, in-circuit test, or functional test when specified in the approved control plan.
Can production be shipped in scheduled or split releases?
Yes, when the commercial and logistics plan defines batch quantities, ship dates, storage responsibility, packaging, shelf-life controls where applicable, and the point at which each release becomes firm. Inventory and rescheduling terms should be agreed before production starts.
Which documents can accompany a production shipment?
The required package should be listed in the RFQ and purchase order. Depending on the program, it may include a Certificate of Conformance, material certificates, electrical-test results, impedance reports, first-article records, microsection reports, traceability data, or customer-requested PPAP elements when agreed in the order.
How should forecast quantity, ordered quantity and shipment releases be specified?
State forecast demand separately from the firm purchase quantity, manufacturing-lot size and each shipment release. Ask which quantity determines pricing, when material or finished-board commitments become binding, and how split deliveries, rescheduling, cancellation and storage are handled. A forecast is not automatically a firm order; the quotation and purchase agreement define the commitment.

Delivery Planning

Define the Release Plan for Each Ship-To Region

For international programs, specify destinations, Incoterms, packaging, batch identification, documentation, and split-delivery rules in the RFQ and purchase order.

North America
USA · Canada · Mexico

Confirm importer details, destination labeling, packaging, customs documents, and whether releases go to one hub or multiple contract-manufacturing sites.

Split ReleasesHub DeliveryBatch Labels
Europe
Germany · UK · Sweden · France

State compliance-document needs, lot traceability, delivery windows, importer responsibilities, and any automotive or medical program records before release.

TraceabilityProgram RecordsDelivery Windows
Asia-Pacific
Japan · South Korea · Taiwan · India

Align receiving-site calendars, packaging labels, moisture or ESD controls, shipment consolidation, and the approval path for schedule changes.

Site CalendarsESD PackagingConsolidation
Middle East
Israel · UAE · Saudi Arabia

Define project-specific documentation, export and import responsibilities, destination labeling, environmental packaging, and firm release dates.

Project DocumentsDestination LabelsFirm Dates

Prepare a Volume Production RFQ

Send the released fabrication files, drill data, stack-up, material, copper, finish and impedance requirements. State forecast demand, firm lot quantity and shipment releases separately, with panel constraints, acceptance criteria, required records and change restrictions. Add BOM, placement data and assembly-test requirements only when assembly is requested.
