Stackup-led multilayer release
High Layer Count PCB Manufacturing
A high layer count PCB is a multilayer board whose stackup, materials, vias, drilling, impedance, thickness and inspection plan must be released as one construction. APTPCB reviews those dependencies before confirming a fabrication route, tolerances, evidence package and quote.
Get an Instant Quote
Layer count
What Counts as a High Layer Count PCB?
| Question | Answer |
|---|---|
| What is a high layer count PCB? | It is a board whose layer count forces controlled registration, sequential lamination and stack-up release — not simply a board with a large number. The construction is released, then built. |
| At what layer count does it start? | Density and registration risk rise continuously, but most programs treat 20 layers and above as requiring a released stack-up and a qualified lamination cycle. |
| Can high layer counts be mass produced? | Yes. Above 72 layers we build in mass production only after a capability review releases the stack-up, drilled-hole reliability and test access for that construction. |
Build capability
Can We Build Above 72 Layers in Production?
| Layer band | Typical use | What we confirm before release | Production condition |
|---|---|---|---|
| Up to 20 layers | Dense digital, industrial control | Impedance targets, drill aspect ratio, copper balance | Standard multilayer flow |
| 20-40 layers | Backplanes, telecom line cards | Sequential lamination plan, registration stack, resin flow | Controlled lamination windows |
| 40-72 layers | High-speed backplane, data center switching | Layer-to-layer registration budget, CAF margin, warpage control | Qualified lamination cycle per stack |
| Above 72 layers | Ultra-dense backplane, advanced computing fabric | Full stack-up review, drilled-hole reliability, test access | Mass production only after a released capability review |
Buyer decision table
What DFM Inputs Does a High Layer Build Need?
| Decision area | Include in RFQ | DFM must confirm | Release evidence |
|---|---|---|---|
| Layer map and stackup | Layer functions, sequence, target thickness, copper and reference planes | Build symmetry, dielectric construction, lamination sequence and finished-thickness feasibility | Approved stackup and fabrication drawing under the released revision |
| Materials | Approved family or performance basis, copper profile, Tg or reliability constraints and substitution rules | Construction compatibility, availability, thickness options and any approved equivalent | Material declaration or traceability level required by the purchase specification |
| Drills and plated holes | Finished-hole sizes, tolerances, board thickness and plating or press-fit requirements | Tool selection, aspect-ratio feasibility, annular-ring risk and plating route | Electrical test plus dimensional or microsection evidence when specified |

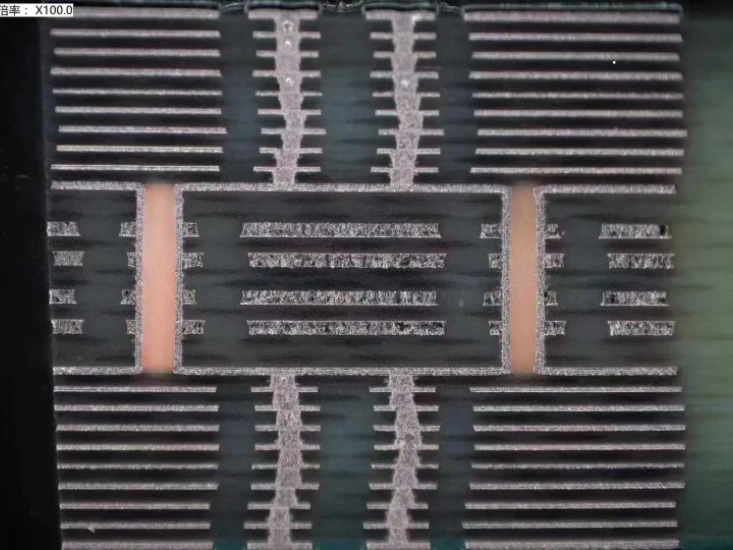

| Blind, buried and filled vias | Connected layers, sequential-lamination intent, fill and cap requirement and pad geometry | Cycle count, via sequence, copper balance and inspection access | Approved via structure and agreed cross-section or process records |

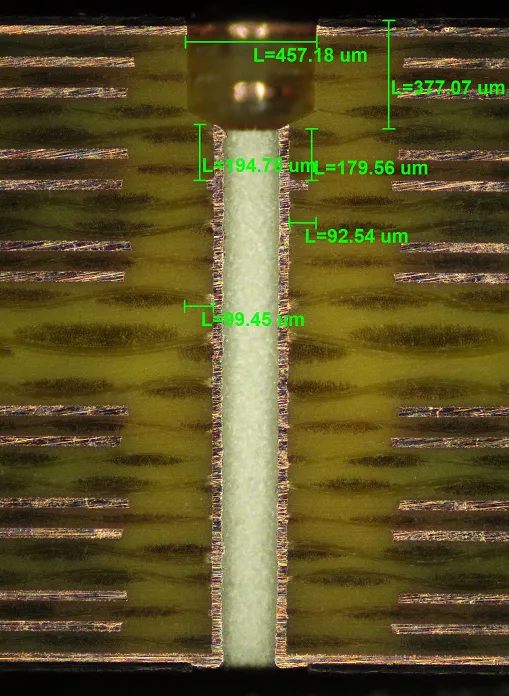

| Backdrill | Entry side, target layer, pad and antipad intent, target depth and residual-stub limit | Depth reference, registration margin, tool access and tolerance stack | Backdrill drawing plus verification method and sampling plan |
| Impedance and channel loss | Net class, target, tolerance, reference layer, geometry intent and loss or coupon requirement | Trace geometry against the proposed material construction and copper profile | Controlled-impedance table and coupon or measurement record when required |
| Board and panel mechanics | Outline, thickness, flatness, connector datums, finished slots and handling constraints | Panelization, tooling, press-fit access, bow or twist risk and depanel route | Released mechanical drawing and first-article dimensional record |
| Quality and change control | Acceptance class, inspection records, sampling, traceability, packaging and revision controls | Which evidence is included, conditional or customer-supplied | Accepted pilot record and frozen production data set |
Layer count, minimum holes, aspect ratio, backdrill tolerance, impedance tolerance, lead time and yield cannot be confirmed independently. APTPCB confirms them only after reviewing the complete construction and the combination of requested limits.
Failure modes and controls
Which Risks Dominate Above 20 Layers?
Hole geometry and plating

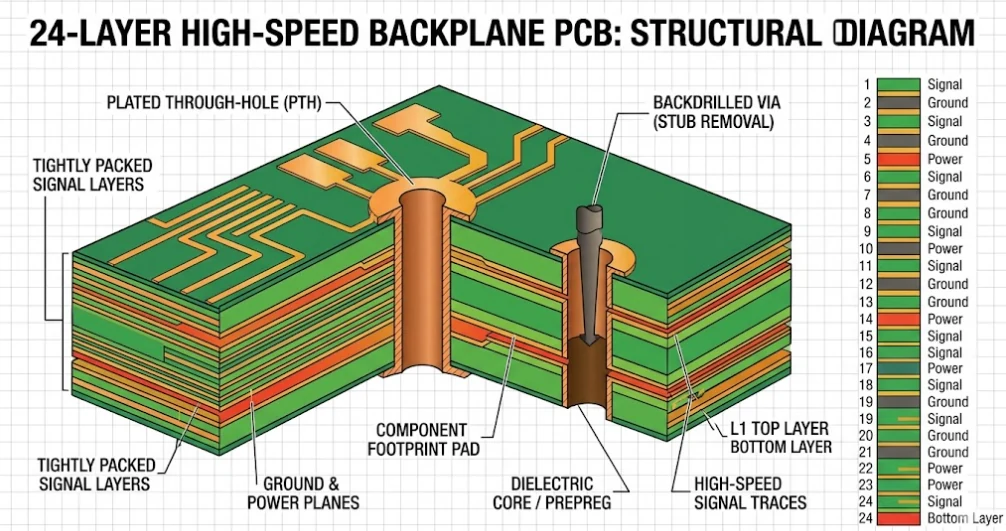

Via transitions and residual stubs
Material, impedance and lamination
Board-family matrix
Which Board Family Fits Your Layer Count?
Server and AI motherboards
Backplanes and midplanes
Switch, router and line cards
ATE and load boards
Control and instrumentation platforms
Regulated or mission-critical hardware
Release sequence
How Does a High Layer PCB Move Into Production?
1. RFQ gate: align one technical revision
The quote should separate confirmed items, conditional assumptions, exclusions and customer inputs. Missing layer mapping, ambiguous finished-hole data, unresolved materials or absent acceptance limits remain RFQ holds.
2. DFM closure: freeze construction and exceptions
Useful reference documents may include IPC-2221 and IPC-2222 for design principles, IPC-6012 for rigid-board performance requirements, IPC-A-600 for acceptability and applicable IPC-TM-650 methods. The customer drawing and purchase specification decide which document, class, revision and acceptance criteria apply.
3. Pilot release: match evidence to failure risk
Sampling, report format and pass or fail limits must be agreed before fabrication. A report without a defined acceptance limit does not close the release decision.
4. Production release: control change, traceability and repeatability
Production should be held when the released data set no longer matches the approved stackup, via architecture, impedance table, mechanical drawing or evidence plan.
Frequently asked questions
High Layer Count PCB: Questions Before RFQ
What is a high layer count PCB?
How should the required PCB layer count be selected?
What determines whether a high layer count design is manufacturable?
When are HDI, blind or buried vias, or backdrill needed?
How should laminate be selected for a high layer count PCB?
What files are needed for a high layer count PCB quote?
Which inspection records can be specified for pilot release?
When are layer capability, tolerances and lead time confirmed?
How is a high-layer-count PCB production request reviewed?
Distributed-team handoff
One release package for engineering, sourcing, quality and production
High layer count programs fail when each function works from a different assumption. The handoff below keeps the construction and acceptance basis traceable across teams and sites.
Own the layer map, stackup target, materials, impedance or loss classes, via architecture, mechanical datums and approved design exceptions.
Compare quotes on matched construction, quantities, material assumptions, tooling, evidence, exclusions and schedule conditions rather than layer count alone.
Define the applicable purchase specification, class, sampling, inspection records, traceability and objective acceptance limits before pilot fabrication.
Freeze the accepted construction and require approval when materials, panel assumptions, drill data, impedance tables or process evidence change.
Request a high layer count PCB manufacturing review
Send the current fabrication data, layer map, stackup, material and copper requirements, drill and via tables, impedance or loss targets, backdrill notes, quantities and acceptance requirements. APTPCB can then identify confirmed items, open assumptions and release holds before quoting.
